Compliance

Several Jobsites, One Emergency Plan Each, None Borrowed

Verified vs OSHA sources · October 5, 2026

By HazComFastPublished October 13, 20268 min read
Several Jobsites, One Emergency Plan Each, None Borrowed
HazComFastLast reviewed October 13, 2026Verified vs OSHA sources · October 5, 2026

Every company that runs more than one job has seen this plan. It was written for the warehouse job two years ago, then copied to each new site with the name changed on the cover. Page three still sends everyone to "the north parking lot, by the trailer". The current site has no north parking lot. The crew knows it, and so does the inspector who asks a laborer where to go when the horn sounds.

An emergency action plan only works site by site: 29 CFR 1926.35(b)(1) requires emergency escape procedures and route assignments, and 1926.35(e)(3) requires the written plan to be kept at the workplace. A company can write the procedures once, but each jobsite needs its own exits, assembly point, alarm signal, reporting method and named evacuation wardens.

At a glance: Company-wide: evacuation types (1926.35(d)), critical operations (b)(2), accounting for employees (b)(3), rescue and medical duties (b)(4), contacts (b)(6). Site by site: exits and route assignments (b)(1), assembly point, alarm and signals (1926.35(c)), how to report from that site (b)(5), wardens trained before the plan is implemented (e)(1). Written plan kept at the workplace (e)(3). Every change to a site plan means a review with the employees it covers (e)(2)(iii).

What 1926.35 leaves no room to copy

29 CFR 1926.35 never says "one plan per site". It doesn't have to. Read the six minimum elements of 1926.35(b) and three of them can only be answered standing on the site:

  • (b)(1) Emergency escape procedures and emergency escape route assignments. Which way out from the third floor while the stair tower is formed? Which gate when the east side is a crane swing zone? A route assignment names an area and its exit.
  • (b)(5) The preferred means of reporting fires and other emergencies. On one site it's the GC's radio channel 3, on another a cell phone and the site address, which the caller has to know.
  • (c) The alarm. 1926.35(c)(1) requires an employee alarm system, and (c)(2) a distinctive signal for each purpose when it's used for more than one. Three blasts on the air horn can mean "evacuate" on your site and "crane moving" on the GC's.

Then 1926.35(e)(1) asks for a sufficient number of persons designated and trained to assist in the evacuation, before the plan is implemented. Those are people on that site, by name. And 1926.35(e)(3) keeps the written plan "at the workplace". For a contractor, the workplace is the jobsite.

When the plan is triggered by MDA work, the rule is spelled out. 29 CFR 1926.60(e)(1)(i) requires the written emergency plan to identify escape routes for employees at each construction site before the construction operation begins.

What can stay company-wide

Not everything changes with the address. These parts describe how your company handles an emergency, and they can be written once:

  • The types of evacuation you use, full or partial, or shelter in place for severe weather (1926.35(d)).
  • The procedure for employees who shut down critical operations before they leave: cranes, hoists, temporary power, hot work (1926.35(b)(2)).
  • How you account for everyone after evacuation: who takes the head count, against which list (1926.35(b)(3)).
  • Who performs rescue and medical duties, and with what training (1926.35(b)(4)).
  • Who to contact for more information about the plan (1926.35(b)(6)).

Even those need a check on each site, because the names behind the roles change. The company procedure says "the foreman takes the head count". The site plan says which foreman.

What each site fills in

A site plan that starts from the company plan needs, at minimum:

Site itemRuleExample
Areas, with primary exit and alternate1926.35(b)(1)"Levels 2 and 3: east stair; if blocked, west hoist"
Assembly point1926.35(b)(1), (b)(3)"Grass strip at the 1st Ave gate, away from the crane swing"
Alarm and signal for each purpose1926.35(c)"Air horn, three long blasts: evacuate"
How to report from this site1926.35(b)(5)"Call 911 and read the address on the gate sign; then radio channel 3"
Evacuation wardens by name, trained1926.35(e)(1)"Level 1: J. Ortiz. Levels 2 and 3: K. Lee"
Alarm code and reporting instructions posted1926.150(e)(2)At the site office phone and at each employee entrance

The last line isn't part of the emergency action plan, but every jobsite needs it. Under 29 CFR 1926.150(e), the employer establishes an alarm system that alerts employees and the local fire department, and posts the alarm code and reporting instructions at phones and employee entrances.

Keeping site plans in step with the company plan

The second failure comes later. The company updates its plan: a new medical provider, a new head-count procedure after a near miss, a new reporting number. The five site plans written from the old version don't change. Six months on, nobody can say which site runs which version.

A workable rule:

  1. Version the company plan. Each change gets a date, a summary and a reason.
  2. Compare each site plan section by section when the company plan changes, and decide for each section: take the company text, or keep the site's.
  3. Never let the company text overwrite site details. Exits, assembly points and wardens belong to the site.
  4. Go through the change with the crews it affects. Under 1926.35(e)(2)(iii), a changed plan is reviewed with each employee it covers. How often to review an emergency action plan has the three moments OSHA names.

On a multi-employer site, decide who sets the alarm, exits and assembly point, usually the general contractor, and have each subcontractor's site plan point to them. Two assembly points for one building is how head counts go wrong.

How HazComFast handles one plan per site

Write the company plan once. Each jobsite gets its own exits, assembly point and wardens, and when you update the company plan, each site sees what changed without anything being overwritten.

In HazComFast, the plan screen has a "Plan for" selector: the company plan, or one of your sites. Until a site has its own plan, the company plan is the one in effect there, and the screen says so. Creating the site plan copies the company plan's text, and the exits, assembly points, evacuation wardens and site fire hazards start blank, to be filled in for that site.

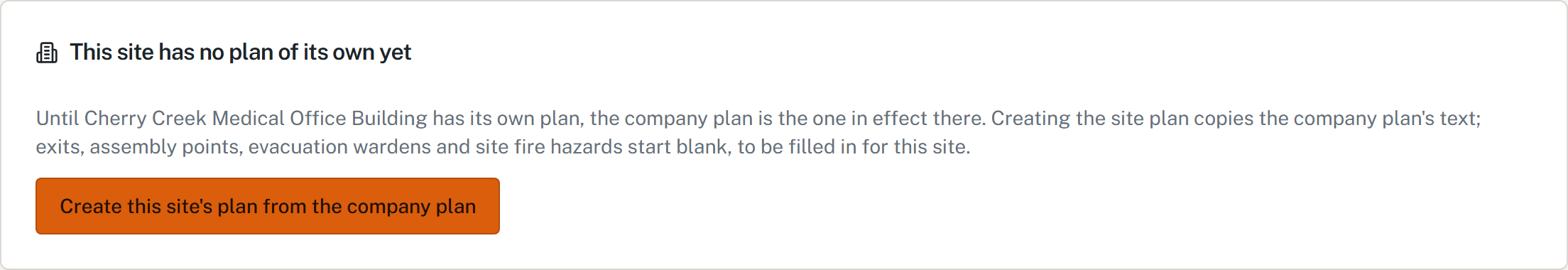

HazComFast emergency action plan for the Cherry Creek Medical Office Building site: This site has no plan of its own yet. Until the site has its own plan, the company plan is the one in effect there. Creating the site plan copies the company plan's text; exits, assembly points, evacuation wardens and site fire hazards start blank, to be filled in for this site. Button: Create this site's plan from the company plan
A site without its own plan runs on the company plan, and the screen says so. The site plan starts from the company text, with the site details left blank.

A draft can be built from what HazComFast already records for the site: its address, the employees assigned to it, the alarm systems declared for it and its flammable (GHS02) products. Only empty sections are filled, and nothing is saved until you review the plan. The chemicals assigned to the site in your HazCom inventory are printed at the end of the plan's PDF, flammable products first.

When the company plan changes, each site plan shows it: "The company plan changed since this site plan was last compared with it. Nothing in this site plan was overwritten." The two texts sit side by side, section by section. You take the company text where it applies, keep the site's where it doesn't, then mark the comparison as done. Exits, assembly points and wardens are never compared.

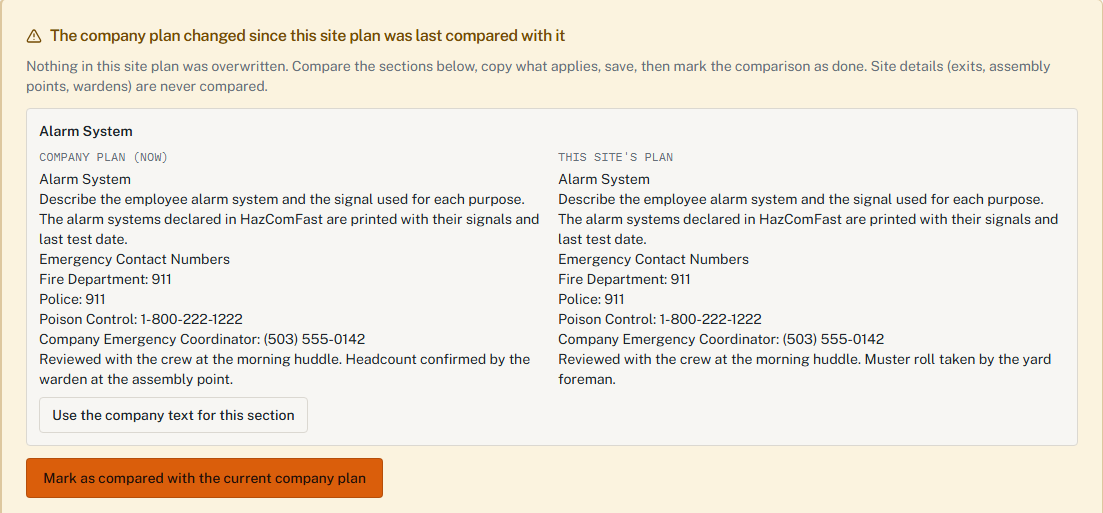

HazComFast site emergency plan: The company plan changed since this site plan was last compared with it. Nothing in this site plan was overwritten; site details (exits, assembly points, wardens) are never compared. The Alarm System section, company plan now and this site's plan side by side, with a button to use the company text for this section, and Mark as compared with the current company plan
The company plan changed: each section shows both texts, and you choose. The site's exits, assembly points and wardens stay out of the comparison.

On the jobsite list, each site card lists the plans in effect there, says whether each one is the site's own plan or the company plan, and marks the drafts.

One company plan, one plan per site

Build a site plan free, or keep the company plan and every site plan in HazComFast, with the differences shown when the company plan changes.

Related: Emergency action plans for construction · How often must the plan be reviewed? · Which OSHA standards require an emergency action plan? · Multi-employer worksite citations


Sources & verification (read on the eCFR, edition of 2026-10-01): 29 CFR 1926.35(a) to (e); 29 CFR 1910.38(b); 29 CFR 1926.60(e)(1)(i); 29 CFR 1926.150(e)(1) and (e)(2). General guidance, not legal advice.*
